PPC Group: 90% of the construction of 2.13 GW photovoltaic power in western Macedonia

The works of renewable energy (RES) in Western Macedonia, whose core are the areas around the Ptolemais, heart, Agios Dimitrios and Amyntaio.

Overall, with their completion, the area’s photovoltaic clusters, the largest in Europe, will produce almost 3,150 GWh electricity – a quantity corresponding to more than 6% of the annual energy consumption throughout mainland Greece.

The Western Macedonia RES projects

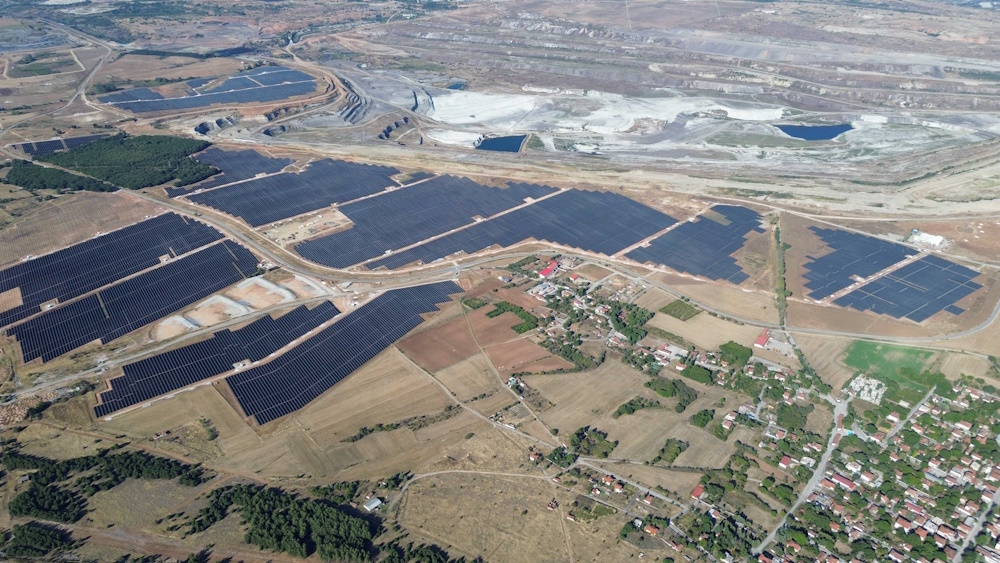

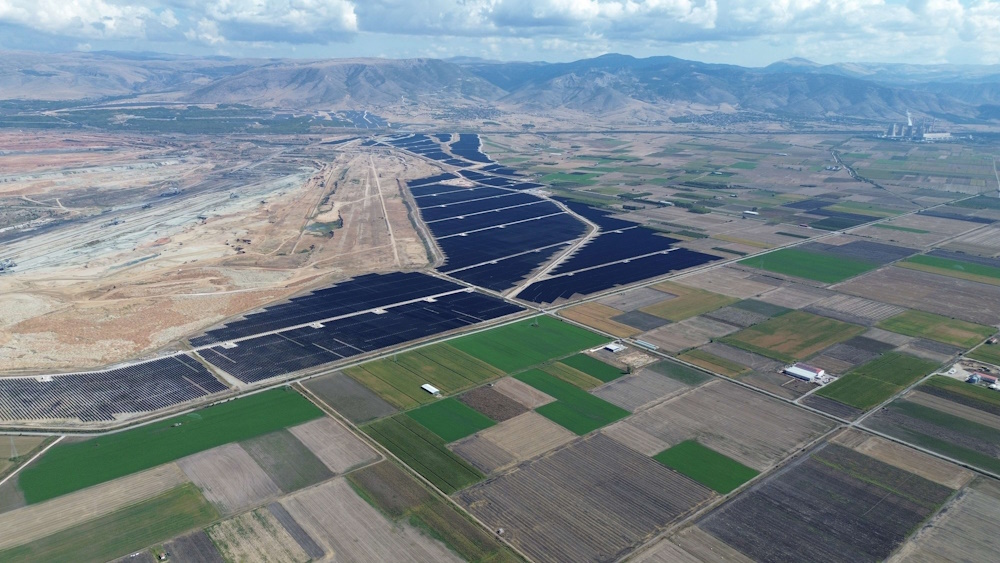

Utilizing the areas of the old lignite mines of Ptolemais, Heart and St. Demetrios, they settled Photovoltaic Stations Total Power 1,190 MWthe construction of most of which (about 90%) has already been completedwhile some projects are already in operation.

With the complete completion of their construction, which is expected in the coming months, the group will only produce about 1800 GWhe from these stations a year. This action will meet the needs of almost 450,000 households while preventing 900,000 TN CO2 release in the atmosphere. These stations include the flagship of the company’s development program, 550 MW.

what about Macedonia?

what about Macedonia?what about Macedonia? what about Macedonia?what about Macedonia?

In addition, in collaboration with the German company RWE AG, it progresses dynamically and The completion of the construction of the 940 MW photovoltaic power stations in the Amyntaio areanear the Amyntaio Power of Power, capable of producing approximately 1,350 GWH per yearcovering the needs of more than 300,000 households and preventing the release almost 675.000 tn CO2.

their luckiertheir luckier

Significant investments in storage systems

Very important part of PPC’s works renewables are Initially installation of two power stations of power storage (Bess) in Ptolemaida (area of ​​Health) and Meliti. Energy storage is the big bet for optimal use of photovoltaic stations, allowing energy to be stored during the day of the day (where surplus is recorded) and its performance after sunset (where a production deficit is observed), while providing a valuable service to the electricity system.

These two stations, totaling 98 MW and 196 MWh capacity, as well as their concomitant projects, are expected to be completed gradually and connected to the electricity system next time.

PPC has already announced that it will invest in the area around € 940 million for 860 MW energy storage projects. Overall, these projects will create over 1,300 jobs during construction and hundreds during operation.

Energy storage projects stand out the two pumping projects, the “natural batteries” using two lakes in an elevation difference between them. This is the project in the heart mine, with a capacity of 320 MW for 8 hours and the project in the South Field mine with a capacity of 240 MW for 12 hours.

deh batteriesdeh batteries

In addition to pumping, the PPC Group will build storage units with a total installed 300 MW batteries.

PPC Deputy Chief Executive Officer Konstantinos Mavros said: “A few months ago, we presented the overall development program of the PPC Group for the wider area of ​​Western Macedonia in the premises of the Power of Heart. During this time, significant progress has been made in the development of the construction of RES and storage with batteries of the Group, which is completely aligned with the timetable set. We move on to the completion of renewable energy and storage projects for a better and greener future. The development of RES projects marks the upgrading of Western Macedonia to a green and high -tech hub. “
